Etiwanda HS Modernization Final Photos

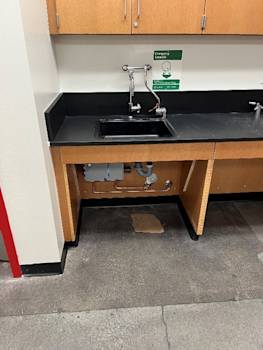

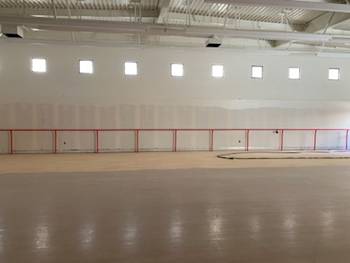

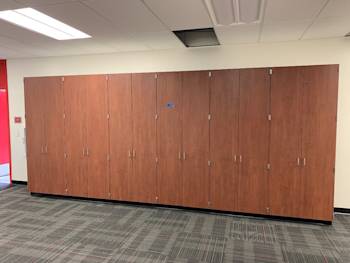

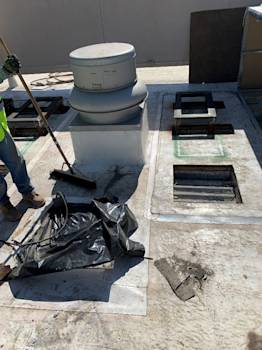

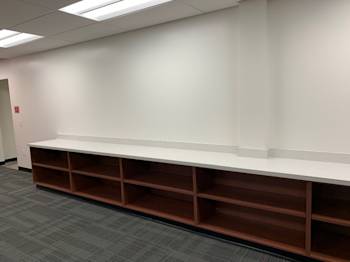

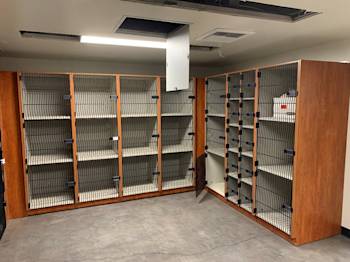

Bldg A (Labs): Casework installation completed in labs. Grinding and polishing of the floors completed. Fume hoods installed. Electrical trim installed. Plumbing fixture final connections completed. Bldg A (Classrooms): Electrical trim and audio/video receptacles installed.

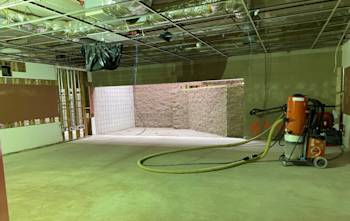

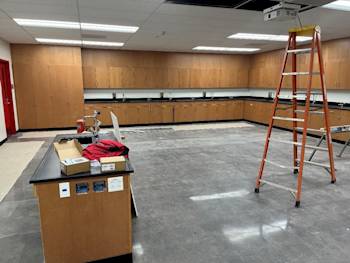

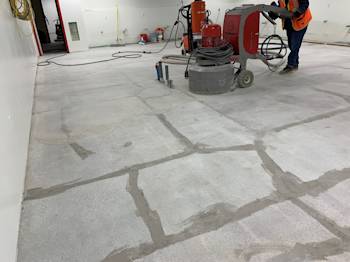

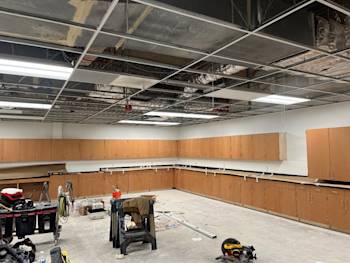

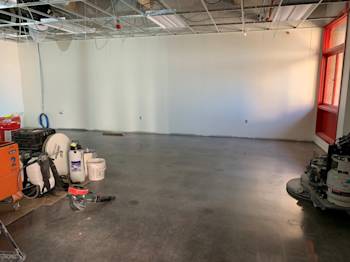

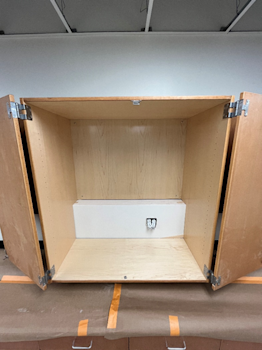

Bldg A (Labs): Casework installation began and ongoing. Epoxy countertop installation began. Floor grinding and polishing began and ongoing. HVAC units installed. T-Bar grid installed. Lights installed in T-Bar grid. Air distribution registers installed in T-Bar grid. Rough in final electrical and plumbing began. Markerboards installed. AV equipment installed. Bldg A (Classrooms): Final coat of paint applied. Acoustical ceiling tiles installed. AV equipment installed. Markerboards installed. AV equipment installed. Markerboards installed. Tackboards installed.

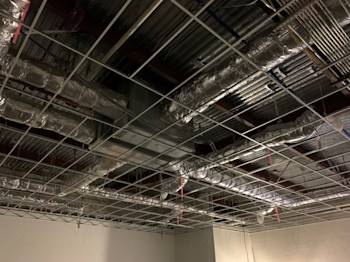

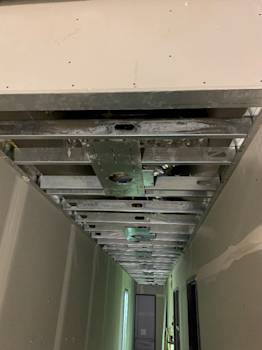

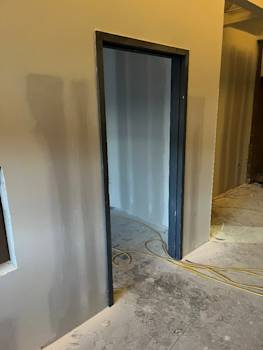

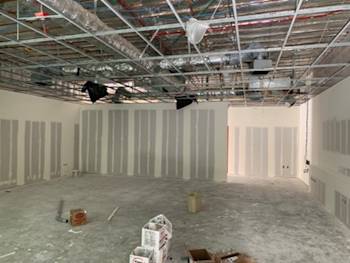

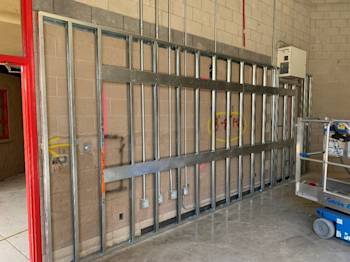

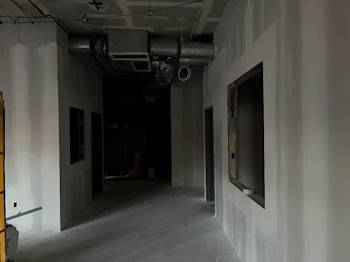

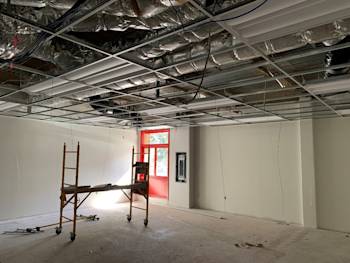

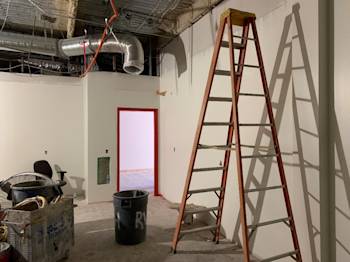

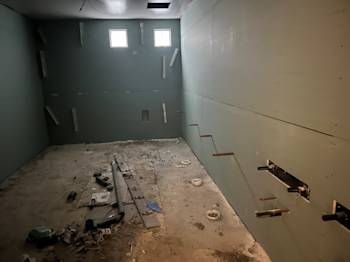

Bldg A (Labs): Walls insulated, double sided, and mud and taped. Walls are primed and painted. Overhead conduits, plumbing, and ductwork installation ongoing. Utility penetrations at HVAC installed. Fire alarm conduit installed. Bldg A (Classrooms): T-Bar grid installed. Lights in T-Bar grid installed. Started installing casework. Grinding and polishing of floors is ongoing. Started electrical trim. Fire alarm conduit installed.

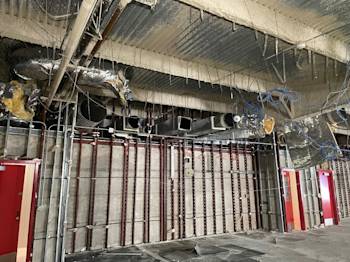

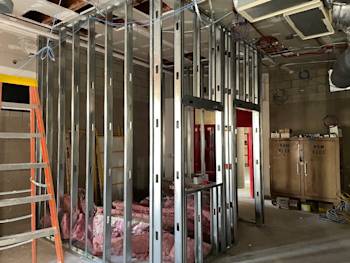

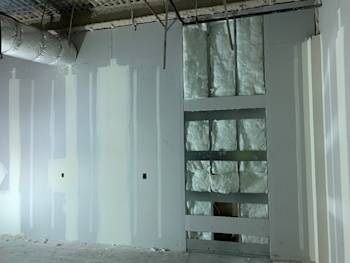

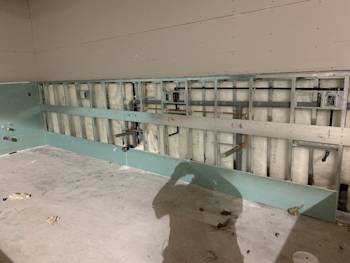

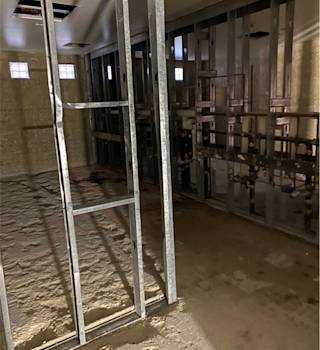

Bldg A (Labs): Lab walls framed. Backing for casework and markerboard/tackboards installed. Installed dyrwall on one side. Rough electrical and plumbing installed. Structural steel HVAC curbs installed above decking. HVAC curbs installed. Firesmoke dampers installed. Bldg A (Classrooms): Ductwork, overhead plumbing, and overhead conduits installed. Walls are mud and taped. Primer paint and first coat painted. Started installing T-bar ceiling grid. Started installing lights in the T-bar grid.

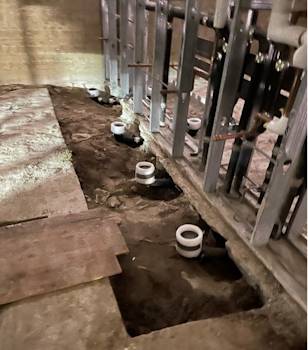

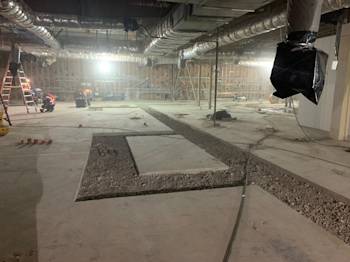

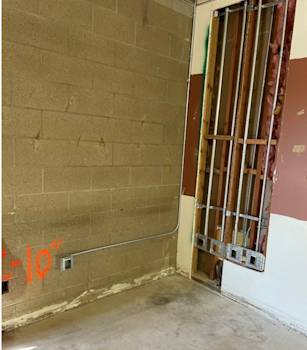

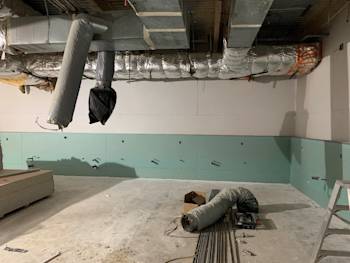

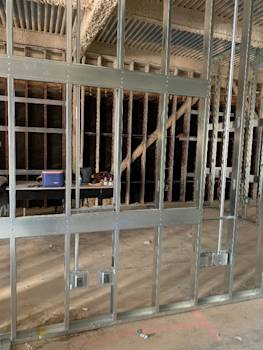

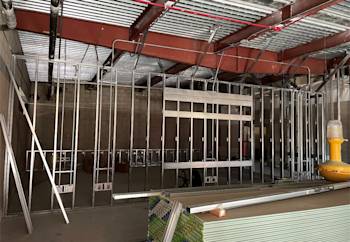

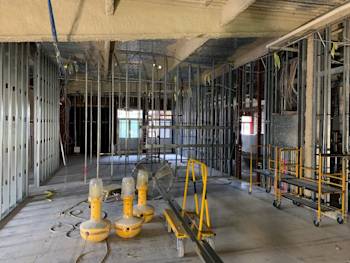

Bldg A (Labs): Installed underground acid waste piping in the labs. Installed underground plumbing and electrical in the labs. Patched back the slab on grade concrete for acid waste trenches. Installed framing and in-wall electrical in the classrooms. Installed insulation and second sided the drywall in the classrooms. Installed door frames in classrooms. Under decking structural steel support for HVAC unit curbs installed.

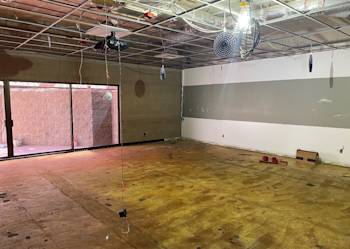

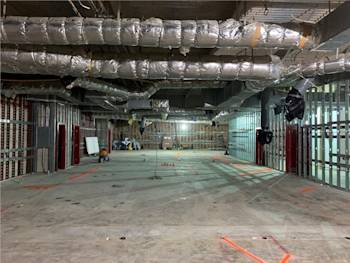

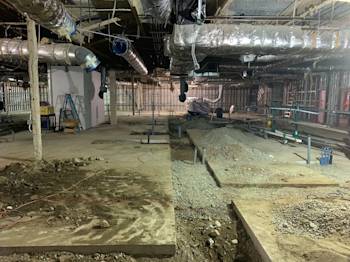

Bldg A (Offices): Installed Wireless Access Points and low voltage devices. Conducted construction clean. Progressed with punchlist items. Bldg C: Conducted construction clean. Installed Wireless Access Points. Tested fire alarm. Progressed with punchlist items. Bldg H: Conducted construction clean. Installed Wireless Access Points. Tested fire alarm. Progressed with punchlist items. Bldg A (Labs): Finished demo of walls, flooring, lights, and T-bar grid. Finished sawcutting slab on grade and started excavating trenches for acid waste plumbing and vents.

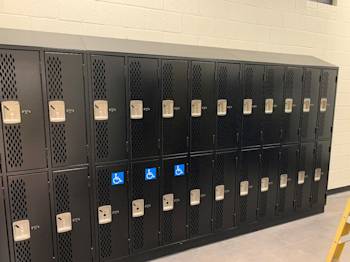

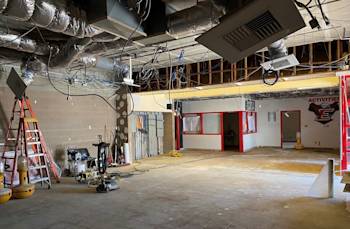

Bldg A (Offices): Installed glazing at doors. Installed new casework. Applied final coat of paint on walls and ceilings. Installed partitions and accessories in restrooms. Grinded/polished floors and installed carpet flooring. Installed lighting. Installed electrical trim. Installed smoke alarm heads and fire alarms. Bldg C: Applied primer and first coat of paint at walls and ceilings. Installed ceiling tiles. Installed tile, fixtures, and accessories in restrooms. Grinded/polished floors and installed carpet flooring. Applied final coat of paint at walls and ceilings. Installed lockers and casework. Installed lighting. Installed plumbing fixtures in classrooms. Installed electrical trim. Started installation of smoke heads and fire alarms. Bldg H: Applied primer and first coat of paint at walls and ceilings. Installed ceiling tiles in classrooms and offices. Grinded/polished floors and installed carpet flooring. Installed lighting. Applied final coat of paint at walls and ceilings. Installed electrical trim. Installed lockers and casework. Installed sink fixtures and water heaters. Bldg A (Labs): Safed off fire alarm. Started demolition of walls, fixtures, T-bar and casework.

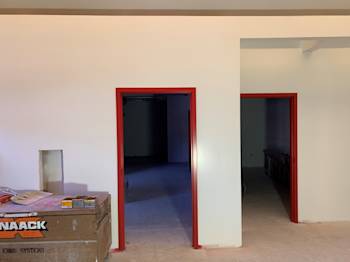

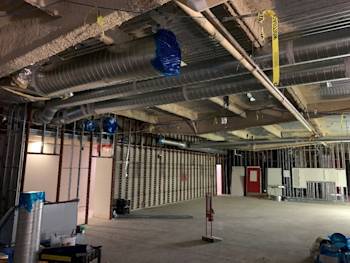

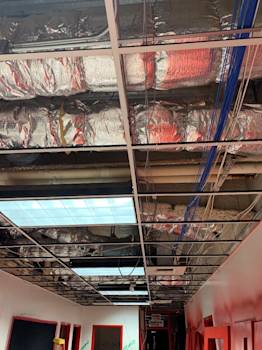

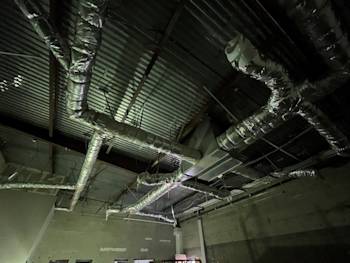

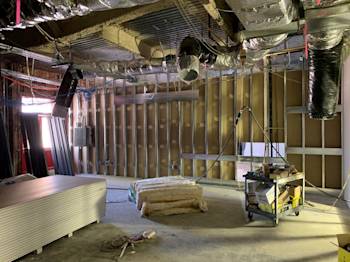

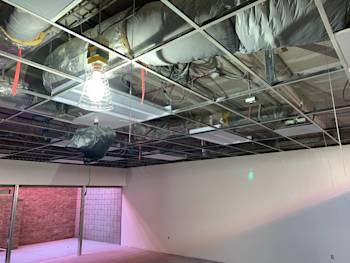

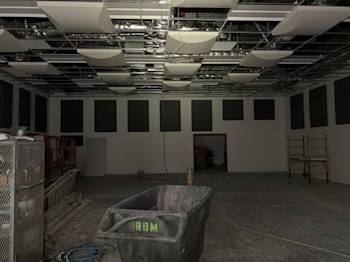

Bldg A (Offices): Taped, mud, and finished walls. Primer and first coat of paint applied at walls. T-Bar grid installed. Installed markerboards. Installed window infill panels. Installed new doors and hardware. Restroom wall and floor tile installed. Began plumbing fixture installation in restrooms. Bldg C: Installed overhead fire alarm, power, and lighting conduits to new panels. Framed new walls. Installed new plumbing and conduits in walls. Backing and hollow metal frames installed. Framed new hard lid ceilings. Gypsum board installed at walls. Installed structural steel framing for heat pump. Installed T-Bar Bldg H: Installed overhead conduits for fire alarm, power, and lighting to new panels. Framed furred walls. Installed new plumbing and conuits in furred walls. Installed backing and hollow metal frames. Installed lights. Installed gypsum board at walls. Installed structural steel framing for heat pump. Taped, mud, and finished walls. Applied primer and paint at walls and overhead structure.

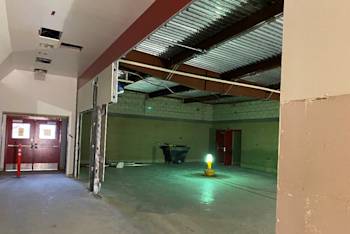

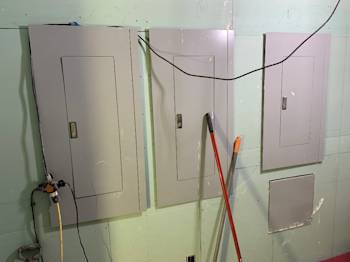

Bldg A (Administration): Installed rough line and low voltage conduits, rough plumbing and gas lines, and ductwork. Installed wall backing and gypsum board. Installed storefront and door frames. Replaced electrical sub panels and distribution panel. Installed hard lid ceiling joists. Began demolition at Buildings C and H.

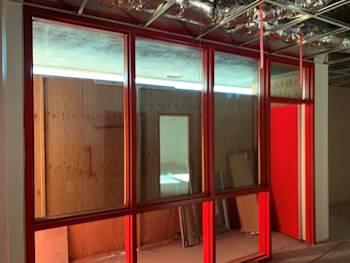

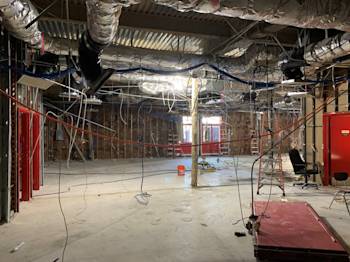

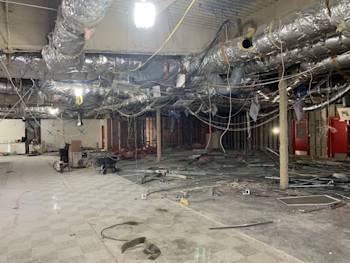

Phase 2: In building A (Offices Area) ceilings, walls, and floors have been demolished. The installation of the wall framing, ductwork, rough electrical, underground plumbing, and overhead gas lines has begun.

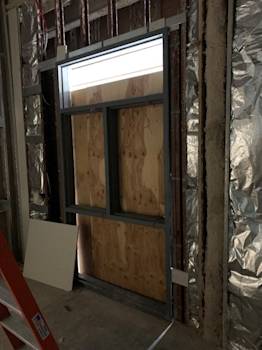

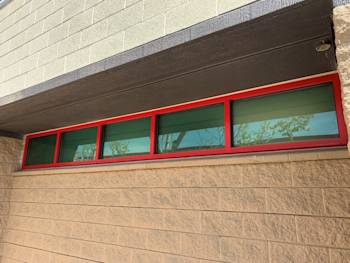

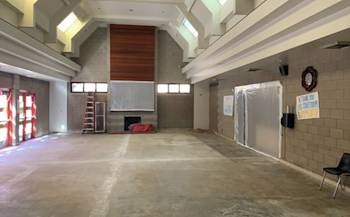

Bldg. E: The aluminum window frames and glass have been installed. The audio/ visual equipment have been installed. The temp doors and hardware have been installed. The final clean was performed. The ire alarm was tested and passed. The owner moved in. Bldg. K: The acoustic casework has been installed. The doors and hardware have been installed. The fire alarms have been installed, tested, and passed. The final cleaning was performed. The owner moved in. Bldg A (Offices): The electrical and fire alarms have been safed-off. The temporary divider wall hase been installed in corridor. Walls and ceiling tiles have been demo'd.

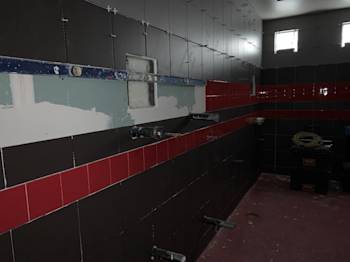

Bldg. E: Installed markerboards in classrooms. Installed storefront systems in classrooms. Repaired damaged roof drain. Flooring final was grinded and sealed. Bldg. K: Installed new supply and return registers. Installed markerboards. Acoustical wall and ceiling panels were installed in band, percussion, and ensemble rooms. Installed new lights. Floor tile was installed in restrooms. New plumbing fixtures, partitions, and accessories were installed in restrooms.
Bldg. E: Installed compression posts at classrooms. Painted the T Bar grid in classrooms. Installed new air registers in both classrooms and offices. Installed Sarnafil roofing. Installed new lighting in both offices and classrooms. Primer and first coat of paint were applied on walls. Bldg. K: Walls were mudded, taped, and finished. Primer and first coat of paint were applied on walls. Tile was installed on bathroom walls. Began light installation.

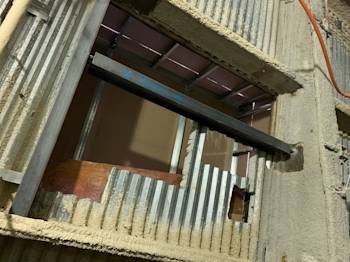

Bldg. E: This month the progress includes the reframing of the storefront wall furrings. Hollow metal frames were installed in the offices. Drywall was installed and has been taped with joint compound applied. The roof opening for the heat pump (HP-3) was removed and covered for weatherproofing. Bldg. K: The progress continued concurrently with the installation of the new ductwork. Low voltage cabling was pulled through the conduit. The roof opening for the heat pump (HP-5) was demoed and covered for weatherproofing. The door frames were installed. Drywall and insulation were installed. Tile backer for the restroom was installed.
Bldg. E: Framed of low wall and chases, raised drains and poured new decks at patios. Pulled in new line conductors. Drywall installation began. Abatement was completed. Bldg. K: Framed new walls and installed backing. Installed steel columns at the expanded door openings. Continued Electrical Rough-in.
Bldg. E: Framing layout occurred. Overhead electrical conduits were installed. Pavers were removed. Storefronts were abated and removed. Bldg. K: Framing layout occurred. Overhead electrical conduits were installed. Plumbing in-wall rough-in completed at restrooms. Duct work was demolished.
The first phase of the modernization includes Buildings E&K. This is the first of various phases to finalize the modernization of the balance of the Etiwanda campus. Building E: Safe off of Electrcial occurred. Demolition began. Building K: Safe off of Electrcial occurred. Demolition began. Abatement of Restroom Tile is complete.
