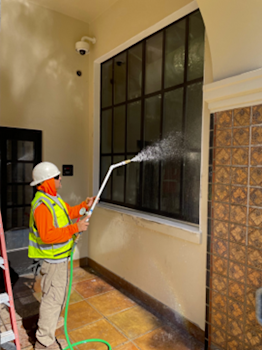

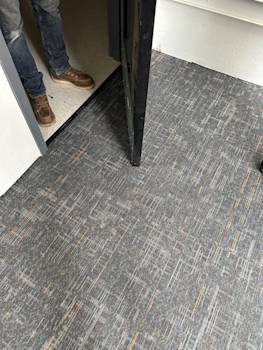

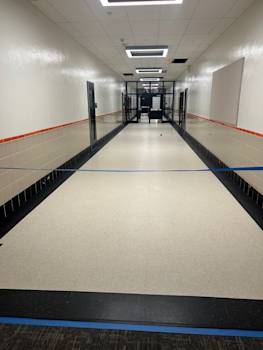

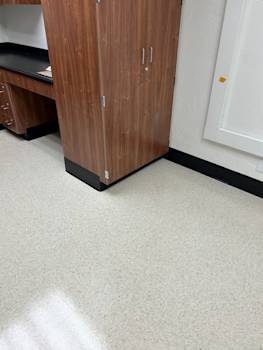

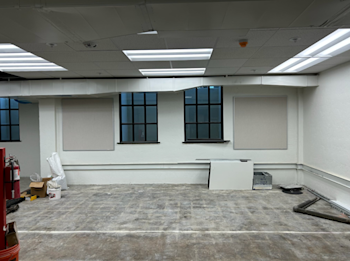

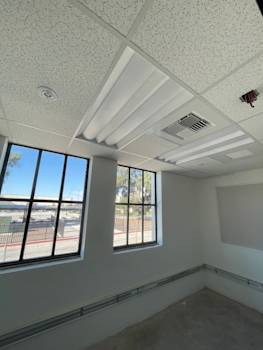

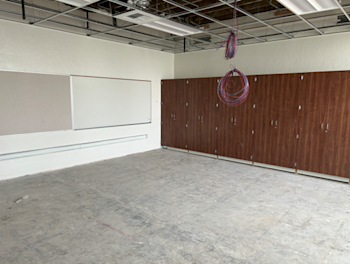

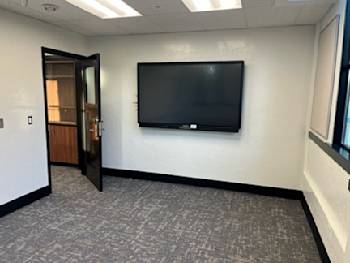

During the month of March, the following has occurred: In the basement, flooring and base installation is in progress. The waxing is in progress. The elevator state inspection was conducted and passed. The final paint is in progress. On Level 1, The markerboards and tackboards for the custom areas/sizes have been installed. The flooring installation was completed. The waxing is in progress. The signage completion is pending procurement of new signs. The staining and sealing of built-in cabinets was completed. The final paint is in progress. On Level 2, The signage completion pending procurement of new signs. The projector installation has completed. The floor waxing mockup was approved, and the waxing is in progress. The final paint is in progress.

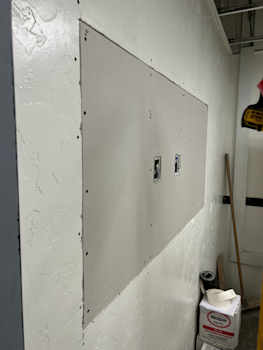

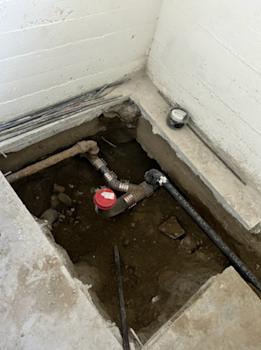

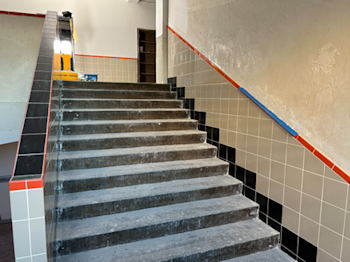

During the month of February, the following has occurred: In the basement the Re-route of the sewer line to the boiler room was completed. Electrical wiremold installation was completed. Elevator finishes were installed and pre-testing is in progress. The flooring and base installation is in progress. On Level 1, The markerboards and tackboards for the custom areas/sizes have been installed. The ceiling tile installation was completed. The flooring installation is on-going. The stair railing and ramp railing installation was completed. The signage completion is pending procurement of the new signs. The staining and sealing of built-in cabinets are in progress. The added/modified office layout work has been completed with less flooring and final paint. On Level 2, The markerboards and tackboards for the custom areas/sizes have been installed. The wiremold, power, data, and fire alarm devices have been completed. The wood trim at the windows and the chair rail installation was completed. The signage completion is pending procurement of new signs. The projector installation has completed. The floor waxing mockup needs to be created. At the site, exterior rails at stairs and light wells have been completed.

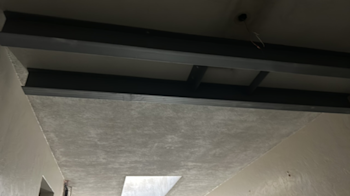

During the month of January, the following has occurred: In the basement, the Switchgear installation advanced and the building has powered lights. The flooring is in progress. The installation of the doors has been completed. The re-route of the sewer line to the boiler room is in progress. On level 1, The markerboards and tackboards for custom areas/sizes have been ordered and are expected next month. The ceiling tile installation have been completed, less new office areas. The framing and drywall have been completed at added/modified office areas. The flooring installation is on-going. The stair railing and ramp railing installation has begun and is on-going. The wood trim on the windows and chair rail installation has completed. Signage installation has begun. The wiremold, power, data, and fire alarm devices are in progress. On level 2, The wood trim on the windows and chair rail installation is in progress. The signage installation has begun. The markerboards and tackboards for custom areas/sizes have been ordered and are expected late February. The wiremold, power, data, and fire alarm devices are in progress. The projector installation in progress. All flooring has been completed. On the site the exterior rails at the stairs and the light wells are in progress and the building painting has been completed.

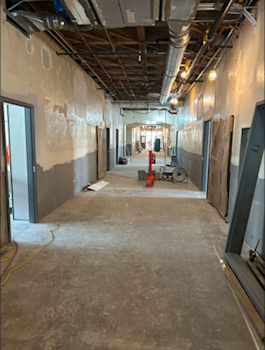

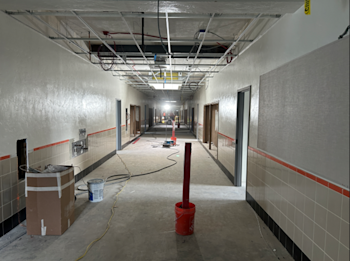

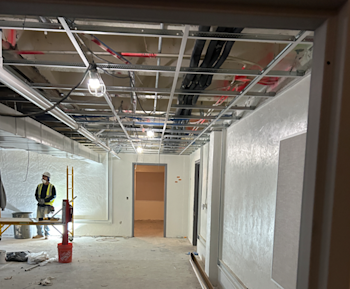

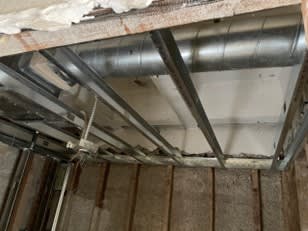

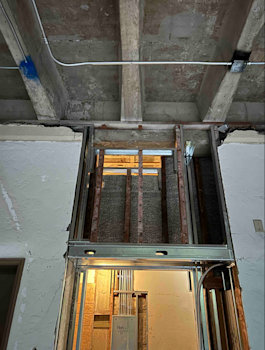

During the month of December, the following has occurred: In the basement, the casework installation has been completed. Mechanical, electrical, plumbing, and lighting installations are nearly complete. The ceiling grid installation has been completed and the ceiling tile installation is on-going. The elevator smoke guard has been installed. The switchgear was received early and the installation/tie-in is in progress. The installation of the doors is in progress. On Level 1, the ceramic tile installation has been completed. The markerboards and tackboards installation has been completed, less the areas for custom sizes. The ACT grid installation is ongoing. The flooring installation has begun and is on-going. The stair railing and ramp railing installation has begun and is on-going. The wood trim at the windows and the chair rail installation has begun. The mechanical registers and lighting installation in the ACT grid is ongoing. Th elevator smoke guard has been installed and the installation of the doors is in progress. On Level 2, the casework installation has been completed. The wood trim at the windows and the chair rail installation has begun. The ceramic tile installation has been completed. The markerboards and tackboards installation has been completed, less the areas for custom sizes. The overhead mechanical, electrical, plumbing, and lighting installation has been nearly completed. The elevator smoke guard has been installed and the installation of the doors is in progress. On the site, the exterior rails at the stairs and light wells are in progress and the building painting in progress.

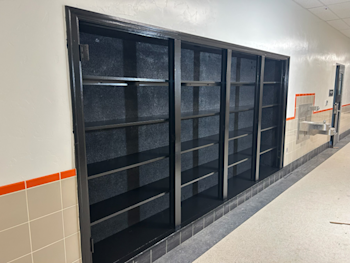

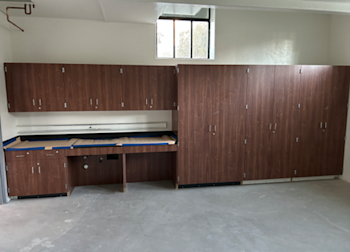

During the month of November, the following has occurred: In the basement, the prime and the first coat of paint has been completed. The wiremold installation is complete. The ACT grid system has begun installation. The tackboards and markerboard installation has begun. The casework delivery for the basement has been received. On Level 1, the ceramic tile installation is ongoing. The installation of the plumbing finishes in restrooms is ongoing. The casework installation is complete. The markerboards and tackboards installation has begun. The ACT grid installation is ongoing. The mechanical registers and lighting installation in the ACT grid is ongoing. The toilet partition and accessories installation has begun. On Level 2, the prime and the first coat of paint is complete. The ACT grid installation is ongoing. The ceramic tile installation is ongoing in the restrooms and corridors. The markerboards and tackboards installation has begun. On the site, the landscape repairs are complete and the exterior preparation and painting have begun.

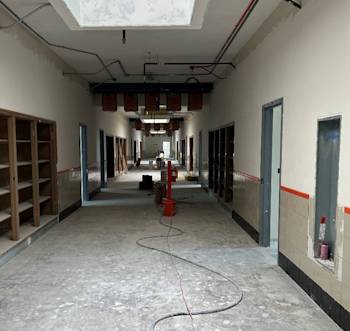

During the month of September, the following has occurred: In the basement, the closing of walls with drywall in the restroom and corridors is completed. The drywall finishing is completed. The prime and the first coat of paint has begun. On Level 1, the ceramic tile installation is ongoing. The installation of plumbing finishes in the restrooms has begun. The prime and the first coat of paint is complete. The wiremold installation is complete. The casework installation is ongoing. The ACT grid installation has begun. The mechanical registers and lighting installation in the ACT grid has begun. On Level 2, the plastering on the exterior walls and patching in miscellaneous areas is complete. The soffit framing and drywall in classrooms is complete. The wiremold installation in classrooms and offices is complete. The prrime and the first coat of paint has begun. The ACT grid installation has begun. The ceramic tile installation is ongoing in the restrooms and corridors. On the Site, the landscape repairs are onoing.

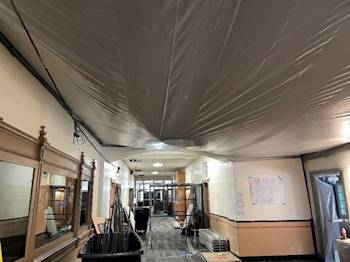

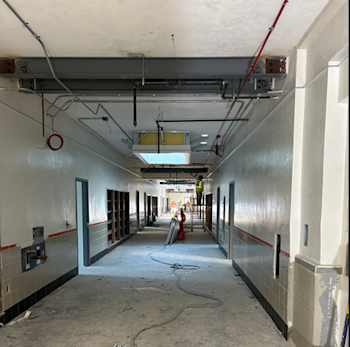

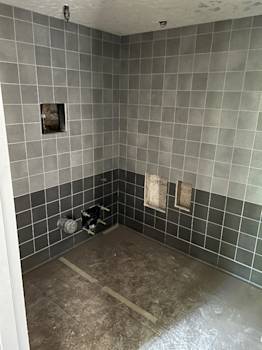

During the month of September, the following has occurred: In the basement, the exterior window installation has been completed. The door frame installation is complete. Closing walls with drywall in the restroom and corridors. The ceramic tile installation in the basement is complete and the drywall finishing has begun. On Level 1, the mechanical, electrical, plumbing and fire sprinkler overhead installation is complete. The exterior window installation is complete. Closing walls with drywall in all rooms is complete. The ceramic tile installation has begun. The prime and first coat of paint has begun. The wiremold installation has begun and the casework delivery has been received. On Level 2, the overhead mechanical, electrical, plumbing and fire sprinkler utilities are complete. The in wall mechanical, electrical, plumbing and fire sprinkler utilities are complete. The plastering on exterior walls and patching in miscellaneous areas have begun. The installation of mechanical steel beams is complete. The exterior window installation is complete, and the roof mechanical units have been installed. On the site, the exterior domestic water line and fire water lines have been tested.

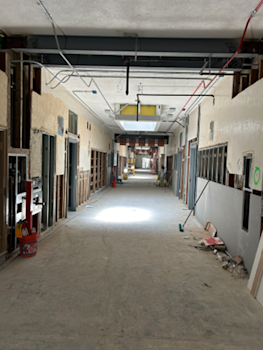

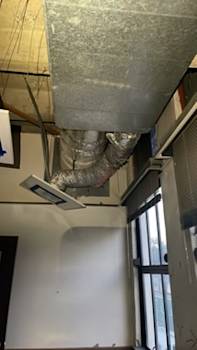

During the month of August, the following has occurred: In the basement, the exterior window installation has begun and the door frame installation is ongoing. The mechanical, electrical, plumbing in wall rough-in is complete. Closing walls with drywall in restroom and corridors. On Level 1, the mechanical, electrical, plumbing and fire sprinkler overhead installation is on-going. The mechanical, electrical, plumbing and fire sprinkler in wall installation is complete and the backing installation is complete. The exterior window installation is on-going. The framing of the door openings is complete. Closing walls with drywall in all rooms has begun. On Level 2, overhead mechanical, electrical, plumbing and fire sprinkler utilities are on-going. The in wall mechanical, electrical, plumbing and fire sprinkler utilities are on-going. The framing of the door openings is complete. The installation of mechanical steel beams is on-going. The exterior window installation is on-going. On the site, the exterior domestic water line and fire water lines have been routed and installed. Pending testing.
During the month of July, the following has occurred: In the basement, the exterior window preparation and waterproofing has been completed. The window installation and door frame installation have both begun. On Level 1, the mechanical, electrical, plumbing and fire protection overhead installation is on-going. The mechanical, electrical, plumbing and fire protection in wall installation is on-going. The backing installation is on-going. The exterior window mockup was created, reviewed, tested and passed. The exterior window installation has begun, and the framing of the door openings is on-going. On Level 2, the overhead mechanical, electrical, plumbing and fire protection’s utilities are on-going. The in wall mechanical, electrical, plumbing and fire protection’s utilities are on-going. The framing of the door openings is on-going. The installation of mechanical steel beams is on-going. The exterior window preparation and waterproofing has been completed the exterior window installation has begun. On the site, the exterior domestic water line and fire water lines have been routed and installed. it is pending backfill and testing.
During the month of June, the following has occurred: In the basement, the overhead mechanical, electrical, plumbing and fire protection’s utilities are on-going. The in wall MEPF’s utilities are on-going. The door frame installation and backing installation have both begun. The exterior window preparation and waterproofing is on-going. On Level 1, the MEPF overhead installation is on-going. The electrical, plumbing and fire protection in wall installation is on-going. The backing installation is on-going. The exterior window mockup is on-going, and the exterior window preparation and waterproofing has begun. On Level 2, the overhead electrical, plumbing and fire protection’s utilities are on-going. The in wall electrical, plumbing and fire protection’s utilities is on-going. The framing of the door openings is on-going. The installation of mechanical steel beams is on-going. The exterior window preparation and waterproofing is on-going.
During the month of May the following has occurred: In the basement, the demolition is complete. The fire sprinkler overhead installation is complete. The overhead MEPF’s utilities are on-going. The framing of the walls and ceilings is complete. The in wall MEPF’s utilities are on-going. The exterior window preparation and waterproofing has begun. Site potholing for the building water and fire water utilities is complete. On Level 1, the MEPF overhead installation is on-going. The MEPF in wall installation is on-going. The wall framing at the door openings and re-installation of the framed walls at the shotcrete walls is complete. The backing installation has begun for the tack boards and marker boards. The exterior window waterproofing mockup is complete, and the exterior window preparation and waterproofing has begun. On Level 2, the demolition at the roof/2nd level is complete. The roof water test is complete, and the framing of the door openings is on-going. The installation of mechanical steel beams is pending final DSA review and approval, and the exterior window preparation and waterproofing has begun.

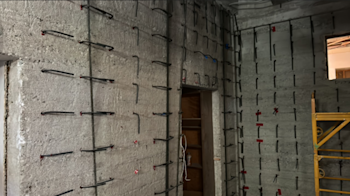

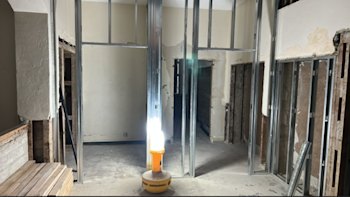

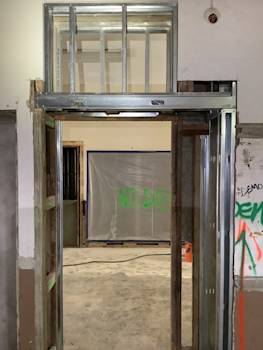

During the month of April the following has occurred: In the basement, the demolition of the crawl space and tunnel is on-going. The fire sprinkler overhead installations are on-going. The overhead MEP’s utilities are on-going. The framing of walls and ceilings is complete. On Level 1, the MEPF (mechanical, electrical, plumbing, fire sprinkler) removal is complete. The demolition is complete. The shotcrete wall installation for the seismic upgrades have been completed. The MEPF overhead installation has begun. The wall framing at the door openings to accommodate ADA requirements and re-installation of framed walls at shotcrete walls has begun. On Level 2, the demolition is on-going at roof/2nd level. The framing of the door openings is in progress. The infill of framing at the interior window openings has been completed and the installation of the mechanical steel beams are on-going.

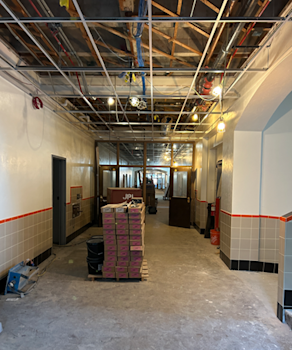

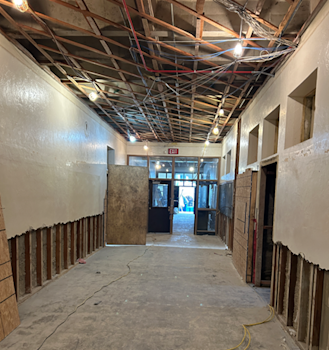

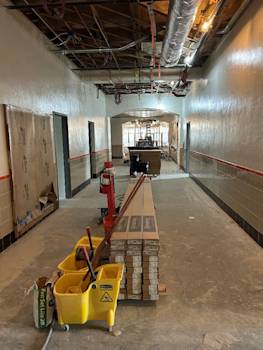

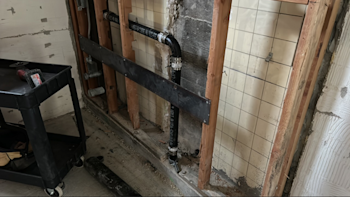

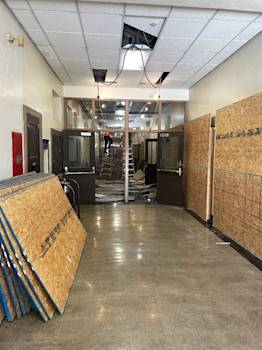

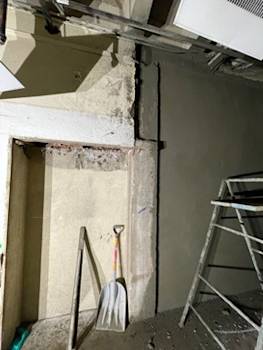

During the month of March the following has occurred: In the basement, plumbing piping removal complete. Underground plumbing trenching and installation is complete. Procedure 5 work is on hold still pending SCAQMD approval. Electrical conduit and low voltage wiring removal is complete. Fire Sprinkler overhead installation has begun. Window removal is complete and window openings have been boarded and secured. On level 1, mechanical, electrical, plumbing removal is ongoing. Demolition of existing space is in progress. The windows are being removed to provide upgraded insulated glass units in the openings, so the openings have been boarded and secured until the new windows arrive. Plaster removal at the interior of windows is complete. Preparation and demolition of plaster at the locations for the new shotcrete walls is complete. Additonal shotcrete walls are being provided for seismic upgrades to the building. The installation of rebar at shotcrete walls is ongoing. Stud framing and drywall removal is ongoing. Shotcrete wall preparation (bushing existing wall surface) was completed in the areas requiring the seismic upgrades. On level 2, mechanical, electrical, plumbing removal has begun, with ceiling removal in classrooms to begin in the next stage. Window removal is complete and window openings have been boarded and secured.

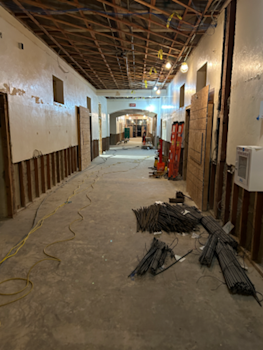

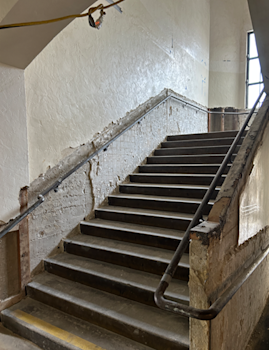

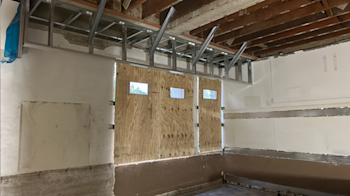

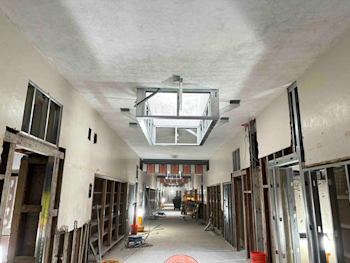

During the month of February the following has occurred: In the basement, plumbing piping removal is ongoing. Lead tile removal is ongoing. Electrical conduit and low voltage wiring removal is ongoing. On level 1, Mechanical, Electrical, Plumbing and Fire Protection removal is ongoing. Abatement has begun. Lead window abatement is ongoing. Plaster removal at the interior of windows is ongoing. Preparation and demolition of plaster at shotcrete walls is ongoing. Removal of ACT tile and grid system is complete. Stud framing and drywall removal is ongoing. Shotcrete wall preparation (bushing existing wall surface) has begun. On level 2, Mechanical, Electrical, Plumbing and Fire Protection removal has begun pending ceiling removal in classrooms due to abatement procedures. Abatement is ongoing. Window removal is ongoing.

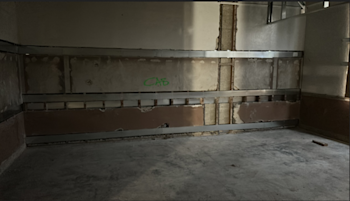

During the month of January the following has occurred: In the basement, salvage items have been tagged, removed from North Hall and handed over to the campus. Pre-Demo TAB was completed. Demolition of basement ACT grid and tile, MEPF system tagging and removal has begun. Flooring demolition was completed. Abatement has begun. On level 1, salvage items have been tagged, removed from North Hall and handed over to the campus. Pre-Demo TAB was completed. Demolition of basement ACT grid and tile, MEPF system tagging and removal has begun. Flooring demolition was completed. Abatement has begun. Window removal at one location was completed for window detail investigation. On level 2, salvage items have been tagged, removed from North Hall and handed over to the campus. Pre-Demo TAB was completed. Demolition of basement ACT grid and tile, MEPF system tagging and removal has begun. Flooring demolition was completed. Abatement has begun. Window removal at one location was completed for window detail investigation.
Modernization of two-story building and basement - new windows, flooring, markerboards, tackboards, signage, paint. Entry accessibility improvements, toilet room modernizations, new fire alarm and fire sprinkler system and structural tier 2 voluntary seismic improvements (shear wall).
